Data Center

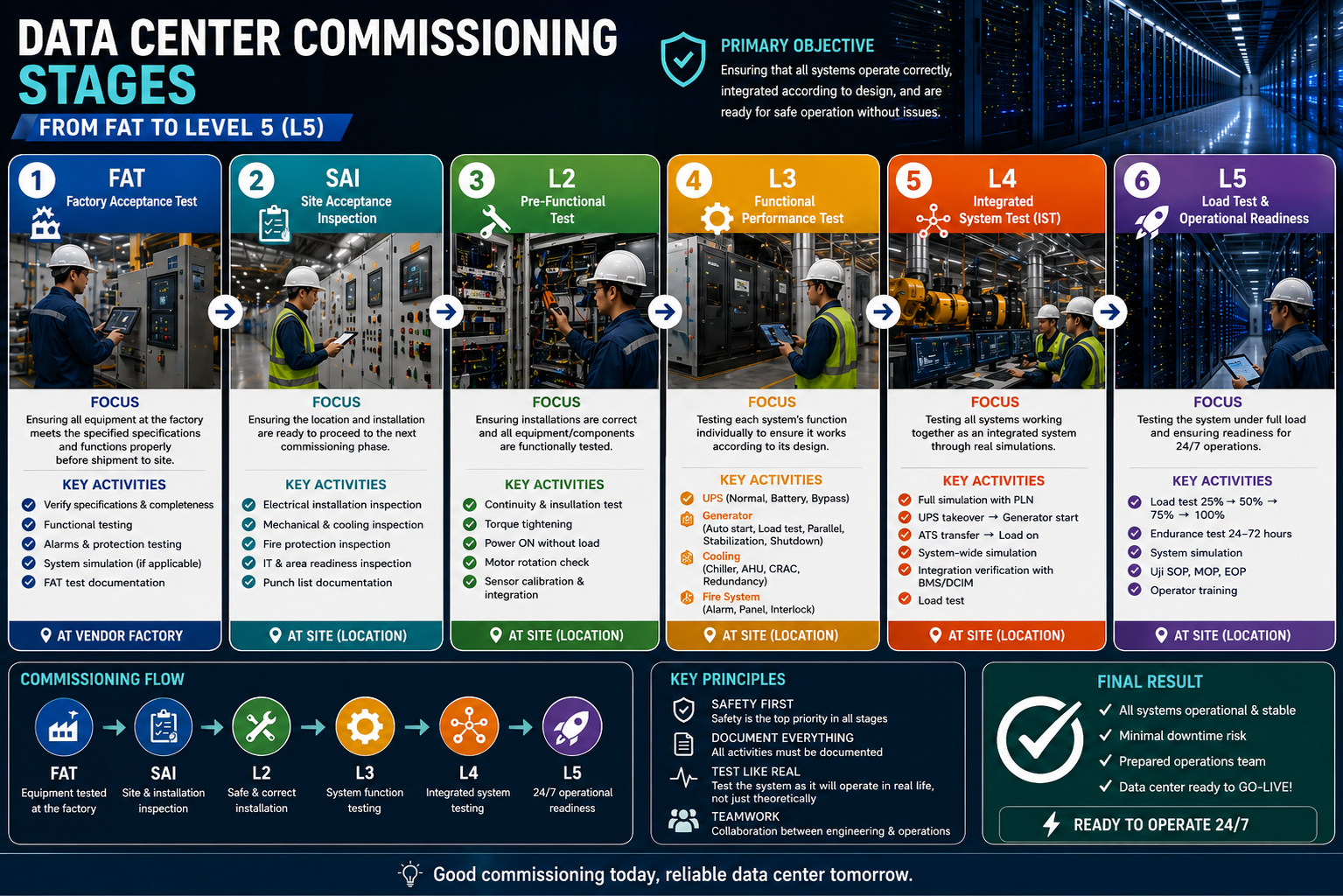

Data Center Commissioning Stages

From SAI to Level 5 (L5)

❄️ Introduction

If you have ever heard the term data center, what probably comes to mind is:
a cold room ❄️, filled with server racks 🖥️, blinking lights, and a place that “must never go down”.
And that is true.
A data center is where data, applications, and digital services operate 24/7 without interruption.
If it suddenly stops, the impact can be:
• Applications failing
• Transactions failing
• Public services being disrupted
• Even billions of rupiah in financial losses
That is why, before a data center is officially used, there is one critical process that cannot be done carelessly:
👉 Commissioning

⚙️ What Is Commissioning?

Simply put, commissioning is the process of ensuring that:
• All systems are installed correctly
• Equipment works according to design
• All systems are properly integrated
• The facility is ready to operate without unexpected problems
Commissioning is not just turning equipment on.
It includes:
• Checking
• Testing
• Simulating failures
• Ensuring the system remains safe and reliable

🔁 Overview of Data Center Commissioning Stages

The correct sequence of data center commissioning is:
👉 FAT → SAI → L2 → L3 → L4 → L5
Meaning:
• FAT: Equipment is tested at the factory
• SAI: Site readiness inspection
• L2–L3: Equipment testing
• L4: Integrated system testing
• L5: Ready for operation

🔧 1. FAT – Factory Acceptance Test

(Testing at Vendor Factory)
FAT is performed before equipment is shipped to the site.
Examples:
• UPS
• Generator
• Electrical panels
• Chillers
🎯 FAT Objectives
• Ensure equipment meets specifications
• Confirm basic functions operate correctly
• Prevent faulty equipment from being delivered
🔍 FAT Activities
• Nameplate verification
• Basic functional testing
• Alarm and protection testing
• Load simulation (if possible)
👉 Analogy:
“Checking a motorcycle at the dealer before bringing it home.”

🏗️ 2. SAI – Site Acceptance Inspection

(Site Readiness Check)
Performed after equipment:
• Has arrived
• Has been installed
🎯 SAI Objectives
• Ensure installation is correct
• Ensure the site is safe
• Confirm readiness for further testing
🔍 What Is Checked?
⚡ Electrical
• Panels installed according to drawings
• Cables properly arranged and labeled
• Grounding available
• No exposed cables
❄️ Mechanical & Cooling
• Chiller / CRAH / CRAC installed correctly
• Pipes properly arranged and insulated
• No leakage
🔥 Fire System
• Fire protection system ready
• Fire alarm panel active
🖥️ IT Room
• Raised floor properly installed
• Hot aisle / cold aisle arrangement matches design
📌 SAI Output
• Inspection checklist
• Punch list
• Approval for next stage
👉 Analogy:
“Checking a house before moving in.”

⚡ 3. Level 2 (L2) – Pre-Functional Test

(Checking Installation Before Trusting the Equipment)
At this stage, the focus is:
👉 Is the installation correct and safe?
🎯 L2 Objectives
• Ensure no installation errors
• Ensure safe initial energization
🔍 Detailed Activities
⚡ Electrical
• Continuity test
• Insulation resistance test (megger)
• Torque tightening verification
• Phase rotation check
• Power ON without load
❄️ Mechanical
• Pipe flushing
• Pressure test
• Motor rotation direction check
• Valve alignment
🧠 Control System
• Integration with BMS/DCIM
• Sensor calibration
• Alarm monitoring test
⚠️ Risks if L2 Fails
• Short circuit
• Motor damage
• Incorrect sensor readings
• Early equipment failure

⚙️ 4. Level 3 (L3) – Functional Performance Test

(Equipment Starts Operating)
At this stage, each system is tested individually (standalone).
🎯 L3 Objectives
• Ensure equipment functions properly
• Verify normal operation mode
• Confirm protection systems work
🔍 Activities
🔋 UPS
• Normal mode
• Battery mode
• Bypass mode
⚡ Generator
• Auto start
• Voltage stabilization
• Shutdown test
❄️ Cooling System
• Temperature control
• Airflow testing
• Redundancy test (N+1)
👉 Important note:
All systems are still tested separately and are not fully integrated yet.

🔗 5. Level 4 (L4) – Integrated System Test (IST)

(Real Condition Simulation)
This is one of the most important stages.
👉 All systems are tested together as one complete ecosystem.
🎯 L4 Objectives
• Ensure systems work together
• Test real failure scenarios
🔍 Example Scenarios
⚡ Blackout Simulation
Scenario:
• PLN power fails
• UPS immediately provides backup
• Generator starts
• ATS transfers power
• Data center remains operational
❄️ Cooling Failure
Scenario:
• One cooling unit fails
• Backup system takes over
• Temperature remains stable
💥 Why Is L4 Critical?
Because:
• Failures often happen during transitions
• Equipment may work individually, but integration can fail
👉 L4 = The moment of truth

🚀 6. Level 5 (L5) – Load Test & Operational Readiness

(Before Go-Live)
This is the final stage before the data center is officially used.
🎯 L5 Objectives
• Ensure system stability under real load
• Ensure operational teams are ready
🔍 Activities
⚡ Load Test
• 25% → 50% → 75% → 100%
• Server load simulation
⏱️ Endurance Test
• Running 24–72 hours
• Performance monitoring
🚨 Failure Simulation
• Failure during high load
• Recovery verification
👷 Operational Test
• SOP (Standard Operating Procedure)
• MOP (Method of Procedure)
• EOP (Emergency Operating Procedure)
• Operator training
📊 Parameters Checked
• System stability
• Temperature
• Alarms
• Team response
🟢 L5 Output
• Ready for operation
• Ready for IT load
• Ready for Go-Live

🧠 Commissioning Summary

Stage Focus
FAT Equipment at factory
SAI Site readiness
L2 Installation verification
L3 Equipment function
L4 System integration
L5 Operation readiness

🔥 Important Insight
Many people think commissioning is only about equipment.
But actually:
👉 Commissioning = System + Integration + People
If one part fails, risk still exists.

🎯 Conclusion

Commissioning is not just a formality.
It is:
👉 the guardian of data center reliability
Without proper commissioning:
• Higher downtime risk
• Greater operational risk
• Unstable systems
With proper commissioning:
• Reliable systems
• Smooth operations
• Prepared teams
And most importantly:
👉 The data center can operate without drama. ⚡🖥️



A Zakki

The author behind IndoXEnergyLab is an energy professional with experience spanning Indonesia's power generation, renewable energy, carbon project, and data center sectors. Passionate about sustainability, ESG, and digital transformation, he uses this platform to share perspectives, data-driven insights, and practical knowledge that help bridge the gap between learning and industry practice. His content is intended for a wide audience, from students and young professionals to experienced energy practitioners. His full professional profile is available on LinkedIn
